This project is not open for feedback. We’re simply informing the community about the upcoming works.

We’re committed to maintaining, operating, and renewing our roads to ensure they meet the community’s needs, as outlined in the Road Network Plan. Regular works, including our Road Reconstruction Program, is vital to keeping our road network safe and reliable.

We are planning to reconstruct Norman Road, Aldinga Beach to address significant pavement and seal defects, including shape deformation, potholes and edge breaks. These works are required to address pavement failure, preventing further deterioration of the pavement layers and ensure the road remains fit for purpose.

This project will involve a full granular road reconstruction to improve road conditions, quality, and longevity. Additionally, the road will be widened to enhance safety, guard rail terminal ends will be upgraded, and two formalised bus pads will be installed at Stop 130.

We are also working in collaboration with SA Water to incorporate the replacement of the SA Water main along this section of Norman Road. Due to the comprehensive nature of the reconstruction and the SA Water works, this project will be delivered in two stages over consecutive financial years, subject to the 2026-27 budget approval process.

SA Water have confirmed that the water main replacement project will commence after the Tour Down Under in early 2026 and will be completed before the end of the 2025-26 financial year. To avoid clashing with SA Water and the winter months, reconstruction works will be deferred to 2026-27 and combined as one project consisting of;

  • Reconstruction of approximately 1.5km from the culvert west of property number 145 through to the new Main South Road seal.
  • Shoulder sealing of approximately 400m from Acacia Terrace to the culvert west of property number 145 to provide a consistent, safe road width from Main South Road to Aldinga.

Key works include:

  • Reconstructing the road surface to a width of 9.5 metres, including 1.5-metre sealed shoulders and 3.25-metre traffic lanes.
  • Replacing four guard rail terminal ends.
  • Upgrading two bus stops at Stop 130 with formalised bus pads.
  • New guard railing over the culvert just west of property number 145.
  • Sealing of the shoulders from property number 145 through to Acacia Terrace

During construction some temporary traffic restrictions will be necessary, traffic management plans will be in place to minimise inconvenience whilst still allowing property access.

We will keep you updated about specific timings and about traffic management measures during the works via this page.

For further information please refer to the concept plan available under Documents.

Concept plan stage 1

Displays the full stretch of Norman Road with surrounding house numbers and property lots. The extent of works is shown, along with stage demarcations. Annotations include street names such as Cox Road and Justs Road. The plan is marked “Not to scale.”

Concept plan stage 2

Shows the road profile for a rural two-way crossfall section, indicating:

  • Two 3.25m lanes
  • Shoulders on both sides
  • Match-in point to be confirmed
  • Locations of adjacent lots and dwellings, including Main South Road and Rogers Road

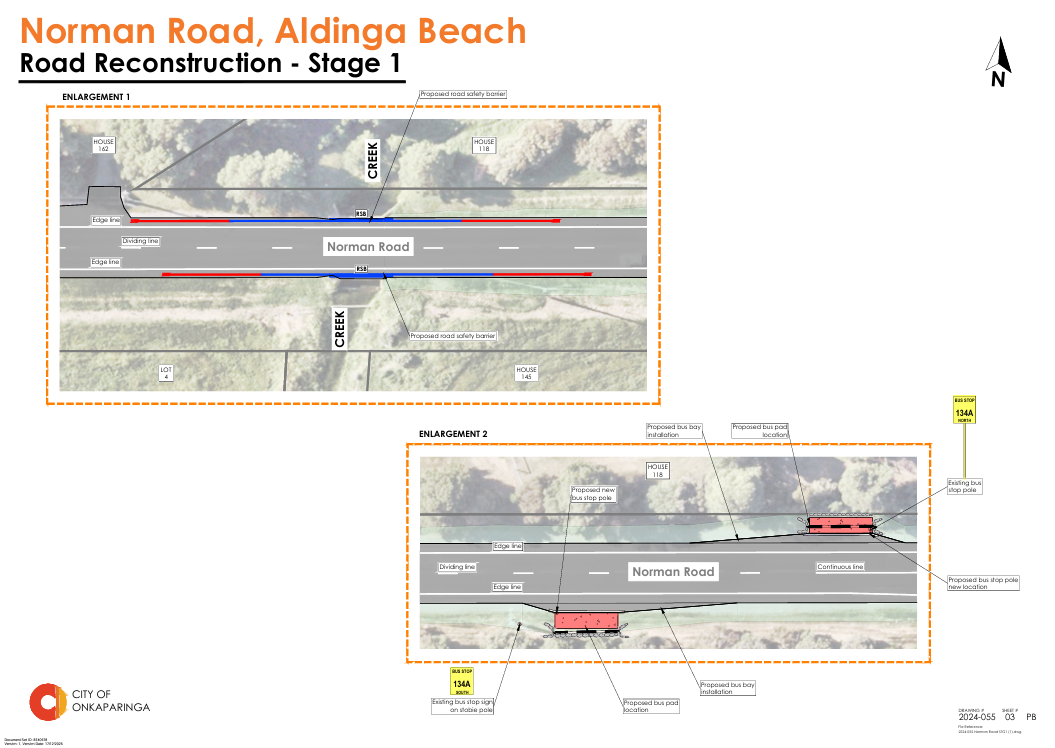

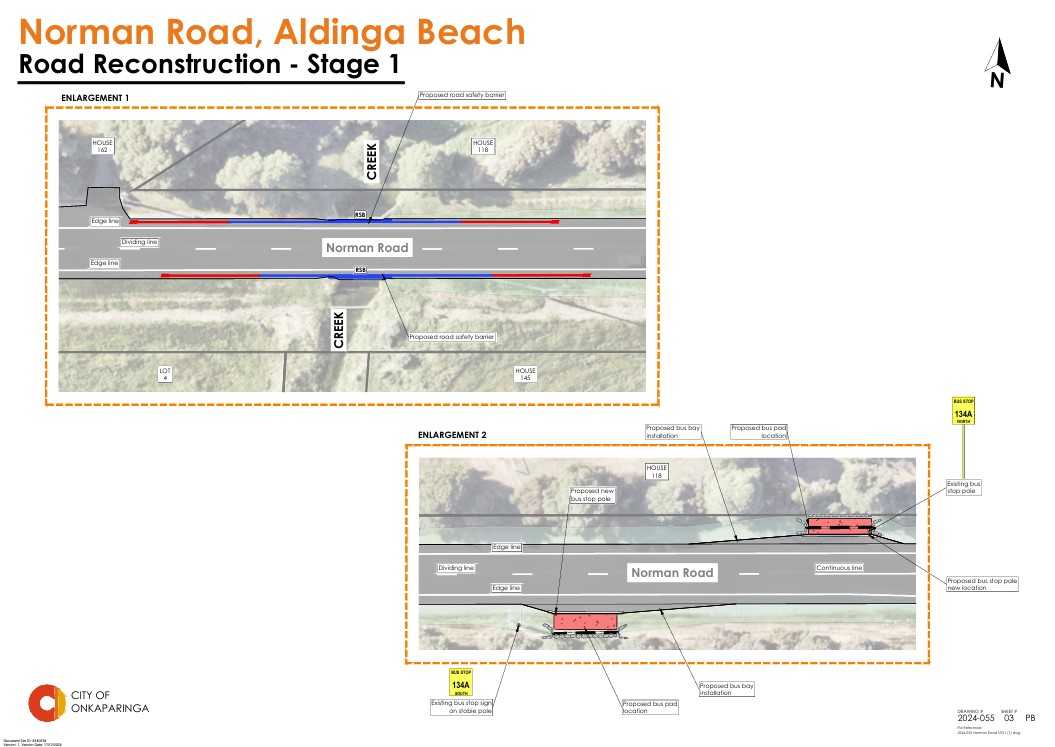

Detailed concept plan sections

Provides zoomed-in views of the bus stop upgrades. Key elements include:

  • Two new concrete bus pads
  • Relocation of bus stop poles
  • Retention of existing stobie poles where applicable
  • Continuous and edge line markings, including a 600mm wide give-way line
  • Replacement of four terminal ends on nearby guard rails
  • References to Bus Stop 134A South and Bus Stop 134A North
