Roads in the McLaren Vale region are becoming safer for everyone, with safety improvements being constructed at 21 intersections

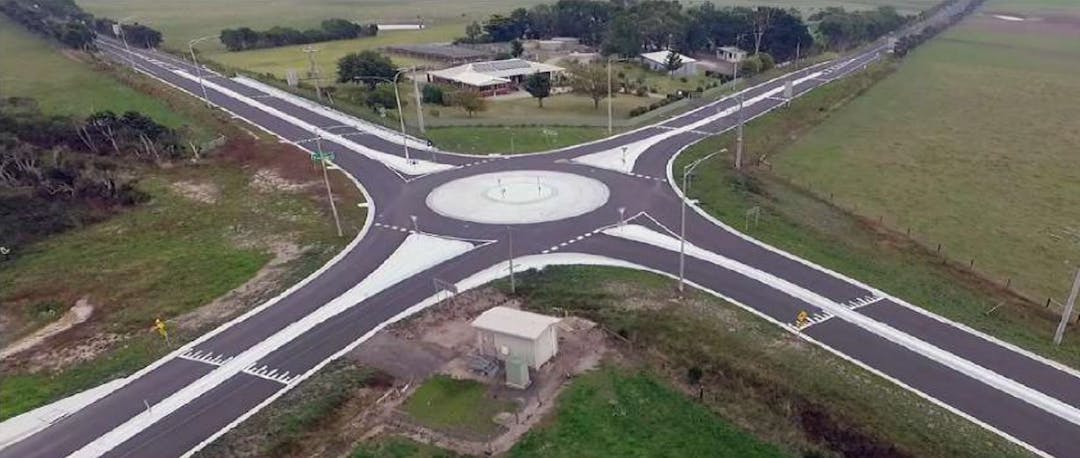

Construction commenced in September on the project’s two most significant upgrades, which involve ‘teardrop’ islands at the Main/Johnston/McMurtrie Road intersection and a compact roundabout at the Chalk Hill/Olivers Road intersection.

Upcoming road closures

Chalk Hill Rd / Olivers Rd / Field St, McLaren Vale intersection

Asphalt laying dates are now locked in, with the majority of the works to be completed at night to minimise the impact on businesses within the area.

The following upcoming road closure dates and times (subject to weather) will apply:

  • Monday 25/11 – Intersection closed 7am – 7am following day
  • Tuesday 26/11 – Intersection closed 7pm – 7am following day
  • Wednesday 27/11 – Intersection closed 7pm – 7am following day
  • Thursday 28/11 – Intersection closed 7pm – 7am following day
  • Friday 29/11 – Intersection closed 7pm – 7am following day (this shift may not be required)
  • Monday 9/12 – Intersection closed 7pm – 7am following day
  • Tuesday 10/12 – Intersection closed 7pm – 7am following day (this shift may not be required)

Find out more about both projects below.

Enhanced warning signage has been installed at 14 McLaren Vale intersections.

We have now begun the six-week commissioning process for RJAWS at the following intersections:

  • Seaview Road, Coppermine Road, and Olivers Road
  • Aldinga Road, California Road, and Olivers Road
  • Malpas Road and California Road

These systems will be fully operational by September 2024.

RJAWS will be installed soon at two additional intersections: Main Road, Malpas Road, and Binney Road; and Bayliss Road and Communication Road. This will also involve changing the priority at the intersection.

Find out more about RJAWS here.

Project timeline

  • Timeline item 1 - complete

    Oct 2022 - March 2023

    Funding announcement, liaison with the Department of Infrastructure and Transport (DIT) and engagement with stakeholders.

  • Timeline item 2 - complete

    July 2023

    Upgrades at 14 of the 21 intersections

  • Timeline item 3 - complete

    Nov 2023 - Feb 2024

    Engagement on the roundabout, teardrop islands and five RJAWS

  • Timeline item 4 - complete

    July - Sept 2024

    RJAWS commissioning process

  • Timeline item 5 - complete

    Aug - Sept 2024

    RJAWS installation at additional intersections of communication Road and Bayliss Road

  • Timeline item 6 - complete

    Sept 2024

    Construction commences on the roundabout and teardrop islands

  • Timeline item 7 - active

    June 2025

    All 21 intersections are complete
